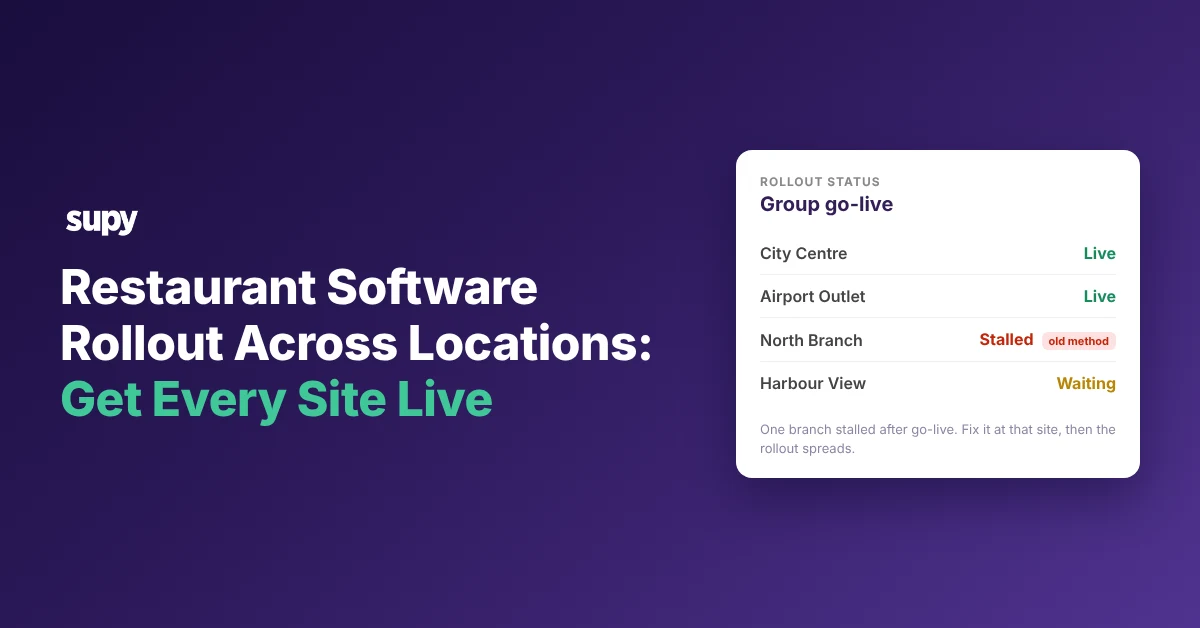

Restaurant Software Rollout Across Locations: Get Every Site Live

Restaurant software rollout status across multiple locations

Where Multi-Site Rollouts Actually Stall

A multi-site software rollout stalls when a problem that stayed invisible at one site repeats at every other site. Four causes account for most of it: branch adoption friction, an unfinished integration or data dependency, a missing approval, and a dirty item master. Each cause has a different fix, so the first job is diagnosis, not a new timeline.

The general pilot-to-full-estate sequence is covered elsewhere in our guide to rolling inventory software across a group, and this guide picks up where that one stops. It covers the specific points where a rollout halts after go-live, and the move for each. The signal differs by stall point, and so does the first move:

Stall pointSignal you will seeFirst move
Branch adoptionA site quietly keeps its old ordering method past go-liveMap the routine onto order templates, pilot one site first
Integration or dataGo-live waits on a POS, a logistics provider, or an export formatSequence the dependency, validate at one site, use a workaround
Decision authorityThe project pauses for a director or franchisor sign-offConfirm who approves before you commit a timeline
Dirty item masterDuplicate items from the catalogue and from invoicesDedupe and standardise one item list before you copy it

The Branch That Will Not Drop Its Ordering Routine

The most common stall is quiet.

  1. The old routine. A branch team has an ordering routine it trusts.
  2. The new search. The new system asks them to search for each item instead of following that routine.
  3. The stall. The new way feels slower, so the team keeps ordering the old way and the rollout stops spreading.

One casual-dining group paused its wider rollout for months for this reason. It piloted the new workflow at a single site alongside the old method before committing further.

Map the routine onto the system instead of asking the team to abandon it.

  • Order templates. Supy order and requisition templates give each location and supplier a pre-built item list.
  • Load template. "Load template" prefills the usual items into an order, so a branch follows its familiar sequence in one tap.
  • Template-only permissions. Permissions can restrict a branch user to templates only, so the fixed routine becomes the fast path.

Pilot one site in parallel with the old method first, prove the template is faster, then roll it to the next location.

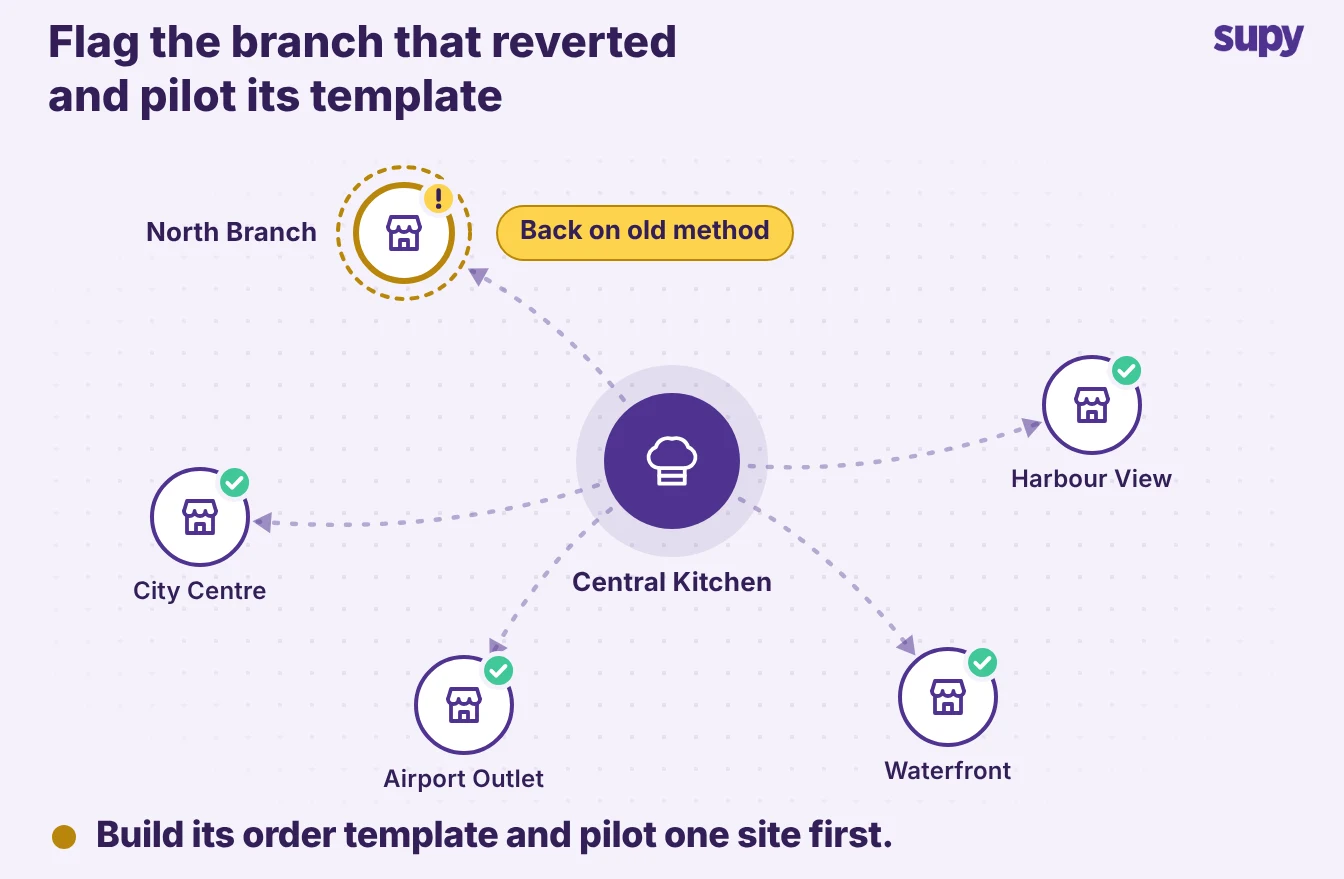

A multi-site rollout map with one branch flagged back on its old ordering method

When Go-Live Waits on Another System

A rollout also stalls on a dependency the software cannot resolve by itself.

  • Logistics. A third-party logistics provider still allocates stock by hand.
  • Point of sale. A point-of-sale system has not been chosen.
  • Invoice format. A supplier's invoice export uses a format the new system cannot read.

Any one of these blocks go-live until someone finishes it, and a project plan alone does not move it.

  1. Sequence it first. Sequence the dependency before the rollout, not during it.
  2. Validate at one site. Validate the connection at one site.
  3. Work around long waits. Where the dependency will take weeks, use a temporary workaround so the rest of the go-live keeps moving.

One group hit a logistics provider's manual allocation and item-code mismatches. A temporary integration kept progress while the dependency was resolved, and go-live moved by weeks instead of stalling outright.

Supy connects to 75+ integrations across point-of-sale, accounting and ERP systems. Most dependencies map to a supported connection rather than a custom build, so confirm the one your estate needs before you set the date.

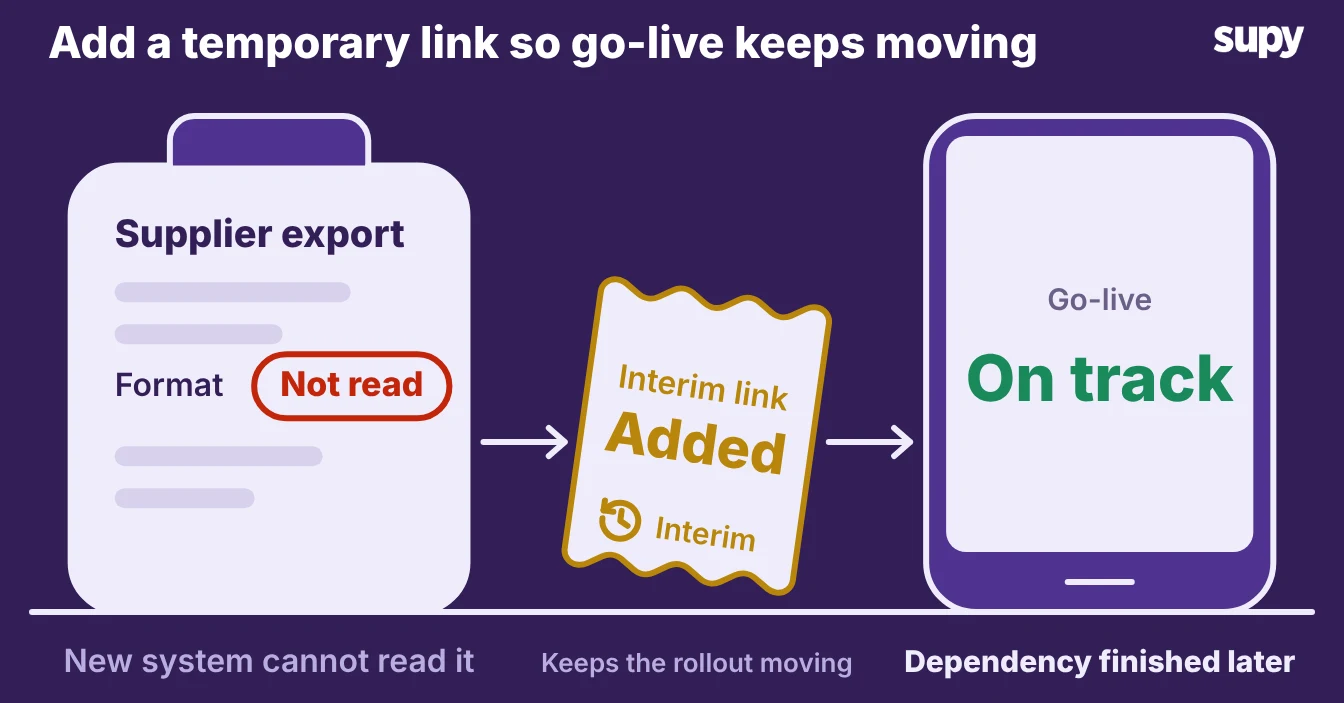

A supplier export the new system cannot read, a temporary link added, and go-live on track

The Approval Nobody Secured

Some rollouts stall on a decision, not a system. The project waits with no restart date, because the people on the rollout cannot give the sign-off it needs.

  • No director approval. A director has not approved the project.
  • A slipped prerequisite. A prerequisite like the point-of-sale choice has slipped.
  • Head-office procurement. Procurement sits with a franchisor's head office rather than the individual location.

Confirm who holds the decision before you commit a timeline. Where authority sits above the location, move the decision to the group or head-office level early. A single site is then never asked to approve something it does not control.

Treat the approval as a prerequisite on the plan, named and dated, not a surprise that surfaces halfway through. Once the system is live, clear approval rules keep that authority visible, so a branch cannot quietly route around it.

A timeline showing the cost of securing rollout sign-off rising from go-live to mid-rollout

The Item List That Multiplies Across Sites

A dirty item master is the stall that spreads fastest, because every new site inherits it. One duplicate comes from the central catalogue and one from a supplier invoice, and together they halt central-kitchen and recipe setup.

Inconsistent entry then creates stock-count variances at every location at once. Copy that list to a new site and you copy the mess with it. Clean one item list before you replicate it.

  • Dedupe pass. Run a dedupe pass that decides which duplicates to merge.
  • New-item standard. Standardise how new items get created, so the next invoice does not reopen the problem.
  • Excel bulk edit. Supplier item lists export to Excel for bulk edit and re-import, which makes the cleanup a single pass rather than an item-by-item slog.

Reusable count templates then clone across sites in shelf order. Parallel counting lets several staff count one site at once and merge the results, which cuts counting time by more than half once the master is clean. Standardise first, replicate second.

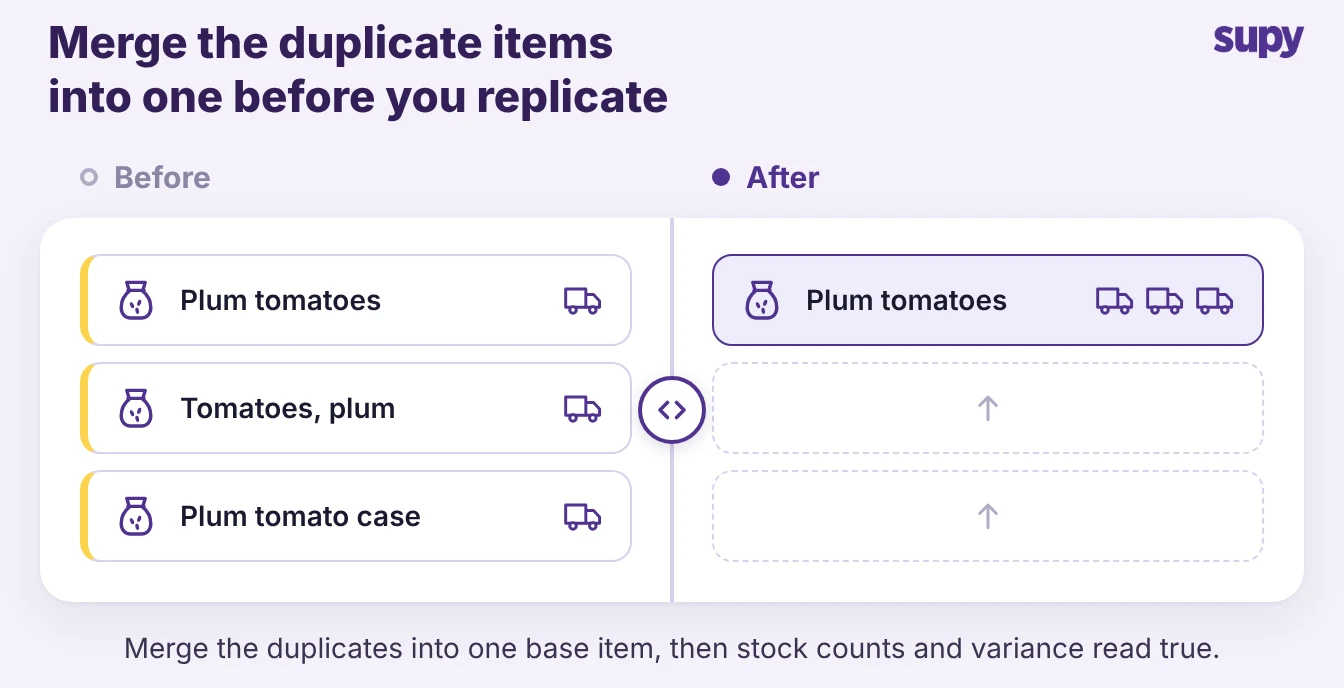

Three duplicate item records merging into one base item

Find your stall point before you touch the timeline.

  • Old routine. If a branch keeps its old routine, build its order template and pilot one site.
  • Waiting on a system. If go-live is waiting on another system, sequence that dependency and validate it at a single location.
  • Paused project. If the project has paused, confirm who approves it and move the decision to the right level.
  • Duplicate items. If the same duplicate items keep appearing, dedupe and standardise one master list first.

A stalled rollout almost always traces to one of these four, and each one clears at a single site before it spreads to the rest.

Book a Demo with Supy - multi-site restaurant software rollout

Ready to optimize your restaurant operations?

Blog

Our operational insights

A colourful arrangement of fresh produce representing restaurant procurement and food service purchasing
Procurement

Restaurant Procurement: A Complete Guide for Multi-Location Operators

Inventory
Procurement

Cost control strategies for multi-unit restaurants

Integration
Inventory

AI‑Driven Procurement: A Step‑by‑Step Guide to Slashing Food Waste and Food Costs

Your questions
answered

Everything you need to know about Supy — from setup to integrations, pricing, and daily use. If it’s not covered here, just ask.

Why do multi-site software rollouts stall after the first site goes live?
+

They stall because a problem the pilot never tested repeats at every new site. One location runs clean, so the rollout spreads, and then the second and third sites hit branch resistance, an unfinished integration, a missing approval, or a duplicated item list. None of these is a software fault, which is why adding features or setting a new timeline does not fix them. Name which of the four is blocking you, clear it at a single site, and only then replicate. Diagnosis comes before any new schedule.

How do you stop a branch from going back to its old ordering method?
+

Map the branch's routine onto the system instead of asking the team to drop it. A fixed ordering sequence feels fast because the team knows it, while searching for each item in a new system feels slow, so the team quietly reverts. Build an order template for that location and supplier, so loading it prefills the usual items in one tap, and restrict the branch to templates where that helps. Pilot the template at one site next to the old method, prove it is faster, then move to the next location.

What should you sequence before a multi-site rollout starts?
+

Sequence every dependency the software cannot resolve by itself before you set a go-live date. That means the point-of-sale choice, any third-party logistics allocation, and the invoice or accounting export formats the new system has to read. Each of these blocks go-live until someone finishes it, and a project plan alone does not move it. Validate each connection at one site first. Where a dependency will take weeks, use a temporary workaround so the rest of the rollout keeps moving rather than waiting for it.

Who should approve a multi-site restaurant software rollout?
+

Whoever holds procurement and system authority for the group should approve it, and you confirm that before committing a timeline. In many groups that authority sits above the individual location, with a director or a franchisor's head office, not the site running the pilot. A rollout that waits on an approval nobody secured stalls with no restart date. Name the approver on the plan, dated, and move the decision to the group level early. A single site should never be asked to sign off on something it does not control.

How do you clean an item master before rolling out to new sites?
+

Dedupe and standardise one item list first, because every new site inherits whatever you copy. Duplicates appear when the same product exists once in the central catalogue and once from a supplier invoice, which breaks central-kitchen and recipe setup. Run a dedupe pass that decides which items to merge, then fix how new items get created so the next invoice does not reopen the gap. Supplier item lists export to Excel for bulk edits and re-import, so the cleanup is a single pass. Standardise the master, then replicate it.

Should you pilot at one site or roll out to every location at once?
+

Pilot at one site first. A single-site pilot surfaces branch resistance, integration gaps, and item-master duplicates while they are cheap to fix, before they multiply across the estate. Run the new workflow at that site in parallel with the existing method, so nothing breaks if the pilot needs another pass. Once the site is clean and the team is faster on the new system, replicate the proven setup to the next location. A full-estate switch skips the step that would have caught each stall at one site.

What is the difference between a stalled rollout and a slow one?
+

A slow rollout is still moving, while a stalled one has stopped with no restart date. A dependency that pushes go-live by a few weeks, handled with a temporary workaround, is a delay you can plan around. A rollout that pauses for an approval nobody secured, or a branch that silently reverts to its old method, has no end date until someone clears the specific block. Treat the two differently. A delay needs a date, and a stall needs you to name the cause and fix it at one site.
